Economic Price Adjustment (EPA) clauses in GSA contracts allow vendors to adjust prices when market conditions change. These clauses protect both contractors and the government from market fluctuations, making long-term agreements more feasible.
Key Takeaways:
- What are EPA Clauses?
Contract terms that enable price adjustments based on market changes. - Types of EPA Clauses:
- Commercial Price List Based: Adjusts prices aligned with commercial pricing.
- Market Indicators Based: Tied to indices like CPI or PPI.
- Cost of Living Adjustments: Reflects changes in labor costs.
- Wage Determination Based: Ensures compliance with updated labor regulations.
- Recent Updates (2024):
- Consolidation into a single clause for simplicity.
- Removal of restrictions like timing and frequency limits for price adjustments.
- Streamlined processes using the eMod system.
- Benefits for Contractors:
- Reduces financial risk during market shifts.
- Simplifies compliance and documentation.
- Supports competitive pricing strategies.
Quick Comparison of EPA Clause Types:
Clause Type | Application | Adjustment Basis |
---|---|---|
Commercial Price List Based | Products/services with commercial pricing | Changes in published prices |
Market Indicators Based | Industry-wide cost changes | Economic indices (e.g., CPI) |
Cost of Living Adjustments | Labor rate changes | Living cost indices |
Wage Determination Based | Labor compliance | DOL wage updates |
Core Elements of GSA EPA Clauses
Price Adjustment Conditions
When it comes to GSA contracts, price adjustments follow specific rules to maintain fairness and consistency. No adjustments are allowed during the first contract year, within 30 days of a prior increase, or more than three times per line item in a 12-month period. Adjustments are typically triggered by cost increases tied to economic indicators, such as the Consumer Price Index (CPI). For example, if material costs rise by 5% over six months, this could justify a price adjustment request.
Now, let’s dive into the different types of EPA clauses used in GSA contracts.
EPA Clause Categories
GSA contracts rely on four main types of EPA clauses, each tailored for specific situations:
Clause Type | Primary Application | Key Features |
---|---|---|
552.216-70 Standard | Commercial products/services | Tied to established commercial pricing |
552.216-70 Deviation | Special contract types | Offers flexibility for unique needs |
I-FSS-969(a) | Service contracts | Focuses on labor rate adjustments |
I-FSS-969(b) | Product contracts | Centers on material cost fluctuations |
Each clause type addresses distinct pricing challenges, ensuring contracts remain adaptable to market changes.
Required Documentation
Contractors requesting price adjustments under EPA clauses must provide detailed documentation to support their claims. This typically includes:
- Market Analysis: Evidence of market conditions driving the adjustment.
- Price Evidence: Current commercial price lists or catalogs.
- Historical Data: Records showing past pricing trends.
- Cost Breakdown: Details on changes in labor and material costs.
- Compliance Proof: Assurance that proposed prices are still “fair and reasonable”.
The exact documentation requirements can vary depending on the EPA clause. For example, service contractors must include updated wage determinations, while product suppliers need to submit supplier records proving material cost increases.
To calculate adjustments, contractors often use formulas outlined in their contracts. A common formula is:
New Price = Original Price x (Index Current / Index Base).
This approach ensures price adjustments are consistent and transparent across different contracts.
Overview of Acquisition Letter MV 22-2022
2024 EPA Clause Updates
On August 5, 2024, the GSA introduced updates to its Economic Price Adjustment (EPA) clauses, aiming to simplify contract management and revamp the price adjustment process for GSA Schedule contracts.
New Single Clause System
One of the major changes is the consolidation of four separate EPA clauses into a single, standardized framework. Here’s how this shift improves the system:
Previous Clauses | Benefits of the New System |
---|---|
552.216-70 Standard | Unified documentation requirements for easier compliance |
552.216-70 Deviation | A more streamlined approval process |
I-FSS-969(a) | Consistency across various contract types |
I-FSS-969(b) | Simplified compliance tracking |
By unifying these clauses, the GSA has removed much of the complexity that previously hindered contract management. This new framework also brings revised price limits, giving contractors increased flexibility.
Changes to Price Limits
The updated EPA clauses also address key price limit restrictions, introducing reforms that align with commercial practices while upholding fair pricing standards:
- Frequency Limits: The cap of three price increases per line item within a 12-month period is eliminated.
- Timing Restrictions: The mandatory 30-day waiting period between submissions is no longer required.
- Contract Period: Restrictions on price adjustments during the first year of a contract are modified.
- End-of-Contract Restrictions: The 60-day limit for final submissions has been revised.
- Ceiling Restrictions: Maximum allowable price increases have been relaxed.
These changes reflect a shift toward greater flexibility for contractors while maintaining a balance with fair pricing principles.
Simplified Adjustment Steps
The updated EPA process now follows three straightforward steps:
- Documentation: Contractors must provide clear evidence, including market justification, to demonstrate fair and reasonable pricing.
- Submission: The new eMod system, designed to work seamlessly with the unified clause structure, reduces confusion and streamlines submissions.
- Negotiation: A revised process ensures ongoing dialogue between contractors and Contracting Officers, preserving the collaborative nature of adjustments.
These updates make the EPA clauses more effective and better suited to today’s market demands. By modernizing the GSA Schedule program, the changes improve both accessibility and efficiency while ensuring pricing integrity.
sbb-itb-8737801
Using EPA Clauses Effectively
Price Adjustment Preparation
Getting ready for a price adjustment starts with keeping a close eye on costs and gathering clear, detailed records. Set up a system to track labor rates, material costs, and overhead expenses for each contract line item. This foundation helps you stay organized and ready to act.
Preparatory Documentation Checklist | Key Elements | Purpose |
---|---|---|
Commercial Price Lists | Current and proposed pricing | Demonstrates alignment with market rates |
Cost Analysis | Breakdown of cost components | Identifies key factors driving changes |
Market Research | Industry price trends | Justifies pricing adjustments |
Economic Indicators | Relevant indices | Validates market-driven changes |
Keep a record of cost shifts and market trends that influence your pricing. This groundwork is especially important with the 2024 updates designed to streamline Economic Price Adjustment (EPA) requests. Once your documentation is in order, you can submit your request through the updated eMod system.
eMod Submission Guide

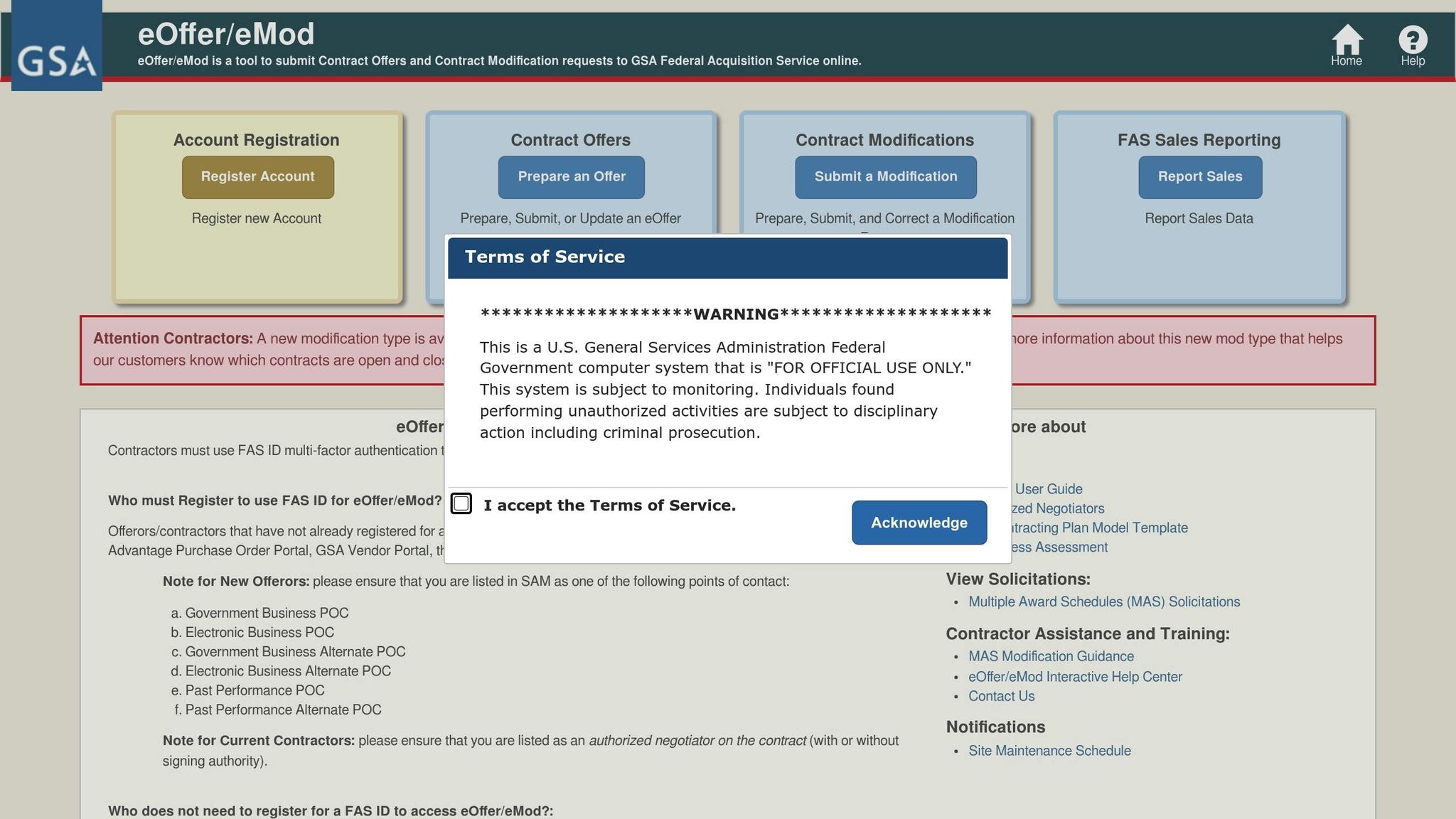

To submit your EPA request, log in to the GSA eMod system and select "Create New Modification" under the Economic Price Adjustment option. Confirm your current contract details before proceeding.
When uploading your supporting materials, include the following:
- Commercial price lists showing price increases
- Detailed cost breakdowns for impacted items
- Market research data reflecting industry trends
- Relevant economic indicators
Write a clear, concise narrative that ties your evidence to the proposed price changes.
"The Contracting Officer and the Contractor shall negotiate a price adjustment in the contract unit prices and its effective date".
Common Mistakes to Avoid
Before submitting your request, take a moment to double-check for these common errors:
Common Error | Prevention Strategy | Impact |
---|---|---|
Timing Violations | Track adjustment windows | Avoids delays or rejections |
Insufficient Documentation | Use thorough checklists | Speeds up the approval process |
Excessive Frequency | Be strategic with requests | Ensures smoother processing |
Poor Organization | Follow standard templates | Makes review easier for approvers |
"Contractors frequently exceed the limitation of three increases per line-item per 12-month period".
To stay on track, maintain a calendar that logs adjustment history and tracks eligibility windows. Aligning your EPA requests with updates to your commercial price lists can simplify your justification process and help maintain consistent pricing.
Summary
EPA Clause Advantages
The updated EPA clauses bring a fresh approach to contract stability by enabling necessary price adjustments. These clauses are particularly beneficial for the long-term GSA Multiple Award Schedule contracts, offering the pricing flexibility needed to adapt to market changes while safeguarding profitability. The 2024 consolidation of EPA clauses marks a shift toward a more efficient system, aligning better with commercial practices and simplifying processes.
Advantage | Business Impact | Implementation Benefit |
---|---|---|
Pricing Flexibility | Helps maintain profitability during market fluctuations | Revised frequency guidelines enhance adaptability |
Commercial Alignment | Lowers compliance complexity | Simplifies the documentation process |
Risk Management | Protects contracts from rising costs | Provides a clear framework for adjustments |
Contract Stability | Ensures long-term contract viability | Balances price modifications effectively |
These enhancements form a solid base for managing contracts more effectively.
Next Steps
To align with the streamlined process introduced in the 2024 updates, contractors should prioritize these actions:
- Track economic trends: Keep an eye on economic indicators and cost patterns that could impact pricing structures.
- Plan for adjustments: Schedule regular reviews to assess when price changes are needed.
- Stay updated: Sign up for GSA updates and participate in available training sessions to stay informed.
These steps will help contractors make the most of the revised EPA clauses and navigate the evolving contract landscape efficiently.
FAQs
How will the 2024 updates to GSA Economic Price Adjustment clauses affect contractors’ ability to change prices?
The 2024 revisions to the GSA Economic Price Adjustment (EPA) clauses aim to provide contractors with more flexibility when adjusting prices to align with market shifts. By simplifying and consolidating the existing clauses, these updates remove previous limitations on the frequency and scale of price adjustments.
Moreover, the extension of moratorium periods through September 30, 2025, offers temporary relief from certain restrictions. This measure is particularly helpful during periods of inflation or volatile market conditions, making it easier for contractors to modify prices. These updates are designed to simplify the process and help contractors maintain competitive pricing in a changing market.
What documents do contractors need to request a price adjustment under the updated EPA clauses?
To request a price adjustment under the updated Economic Price Adjustment (EPA) clauses, contractors need to submit detailed and accurate documentation. This usually involves:
- A copy of the applicable index, survey, or pricing indicator that shows the price change and the date it took effect.
- Any extra supporting documents that the contracting officer may require to confirm the adjustment.
Make sure your submission is thorough and complies with GSA contract guidelines to help expedite the approval process.
How does combining Economic Price Adjustment (EPA) clauses into one framework benefit GSA contract management?
Consolidating EPA clauses into a single framework improves how the GSA manages contracts by cutting down on administrative hurdles and ensuring policies are applied uniformly. This streamlined approach simplifies compliance, making it less complicated for contractors to handle price adjustments across various contracts.
On top of that, this unified system promotes better transparency and efficiency in pricing, which works to the advantage of both contractors and federal agencies. Removing duplicate or conflicting clauses makes the entire process more straightforward and easier to navigate for all parties.
